Structured Cabling Supply and Installation at Secret Paradise, Palawan -- Day 1 to Day 14 Progress Update.

Introduction

The Intercom System Installation Project officially began its first major phase with the start of piping implementation on October 31, 2025. This stage of the project marked a crucial step in establishing the foundational infrastructure for the intercom system across multiple rooms in the facility. Despite facing several on-site challenges and logistical delays, the InstallersPH IT Solutions team diligently carried out the work, ensuring that proper conduit pathways were installed for efficient and secure wiring integration later on.

This report details the team’s progress, the scope of work completed, the challenges encountered during on-site operations, and the overall timeline of the first phase of the project.

Start of the Piping Work.

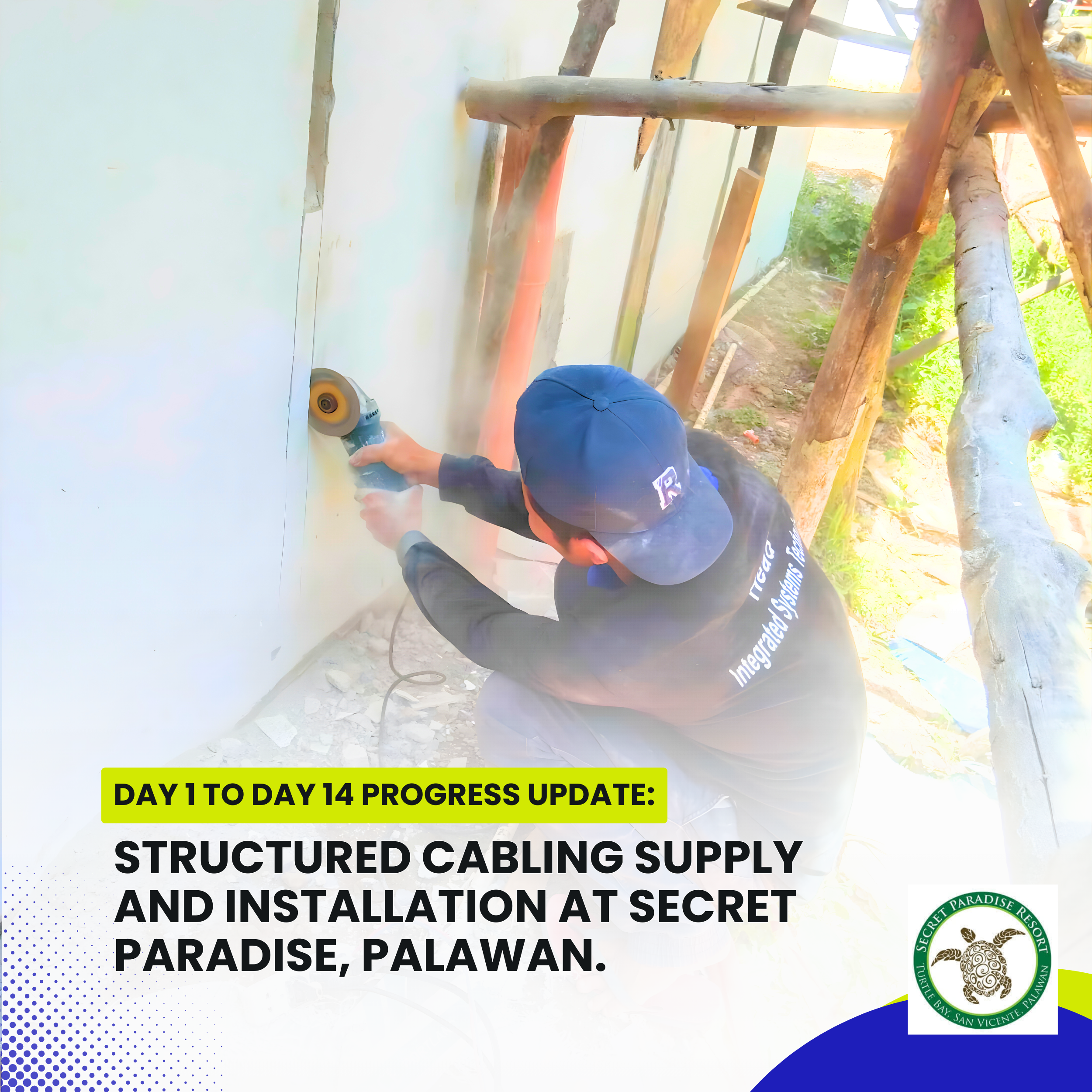

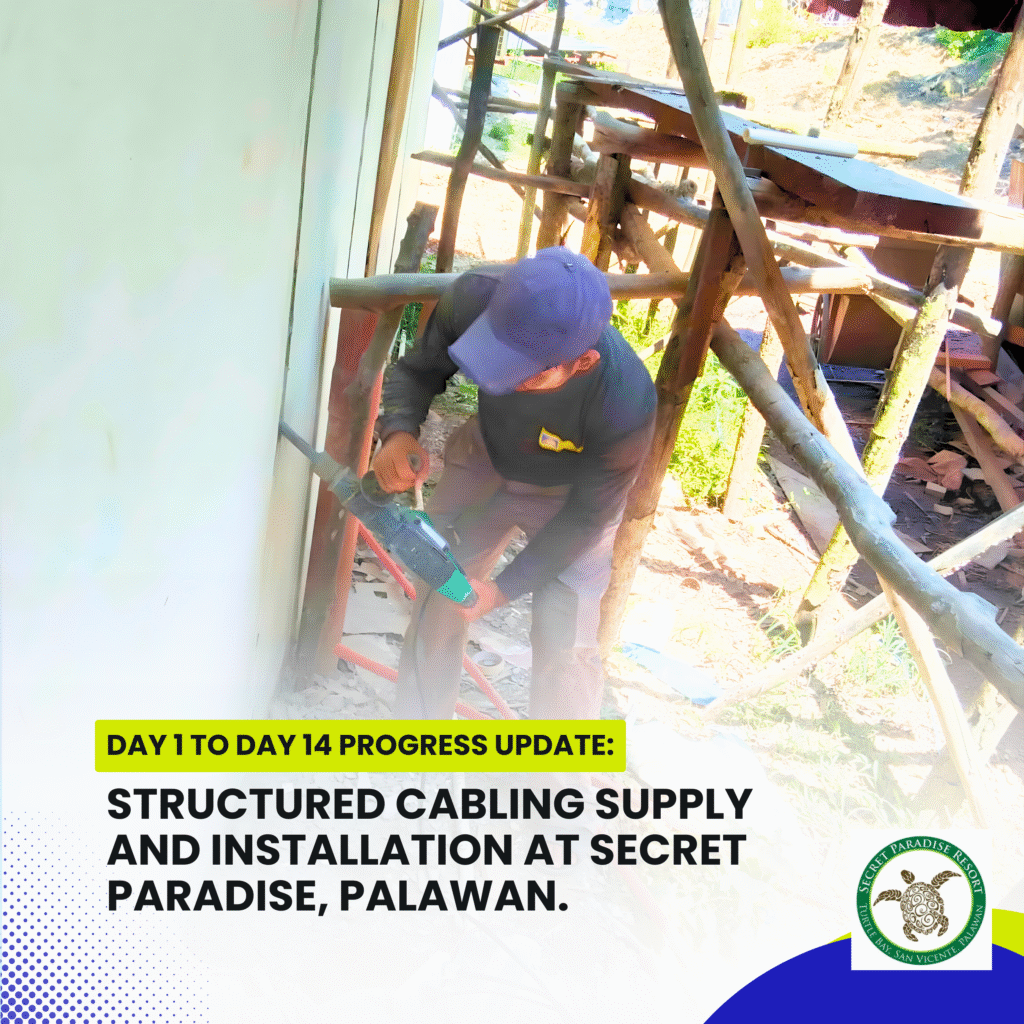

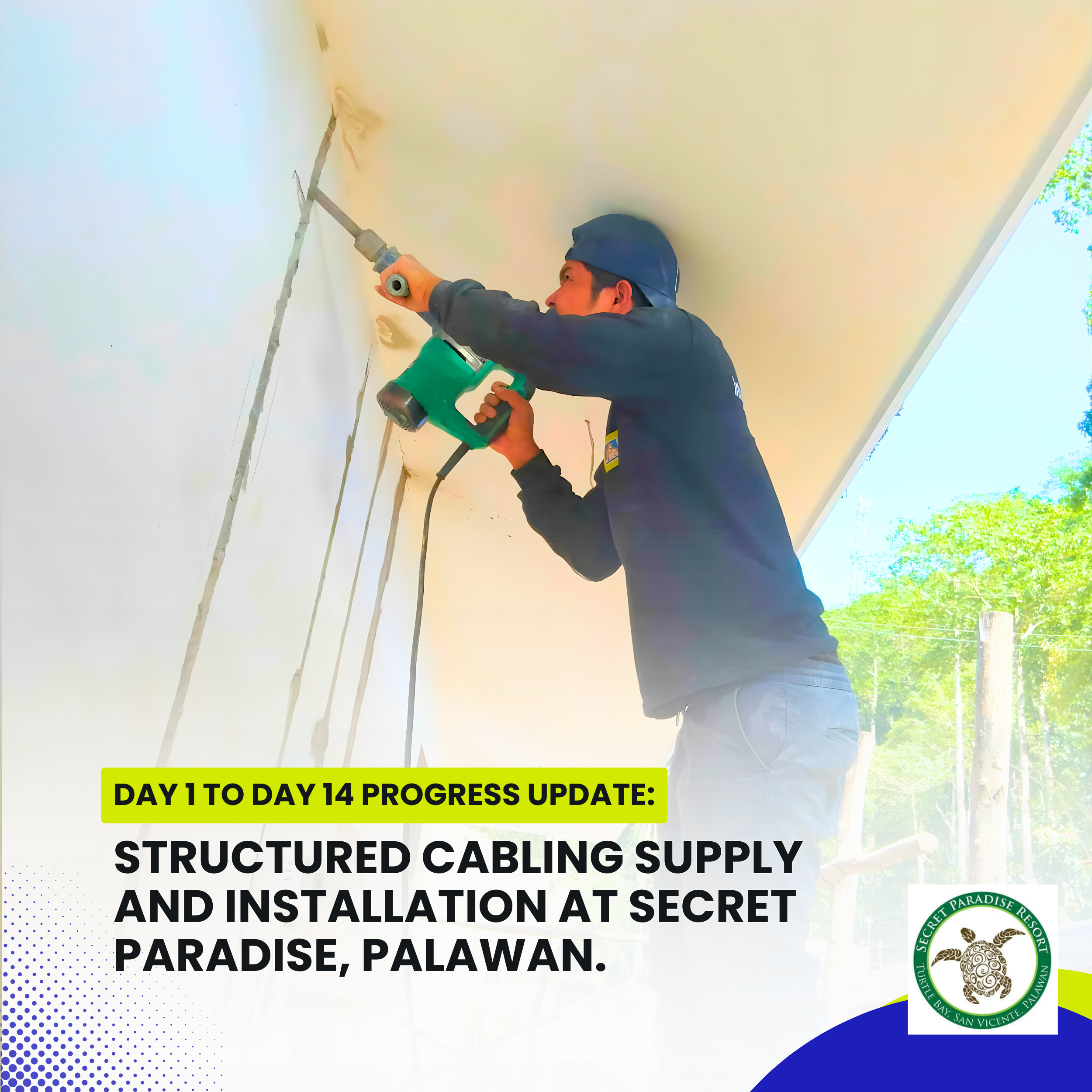

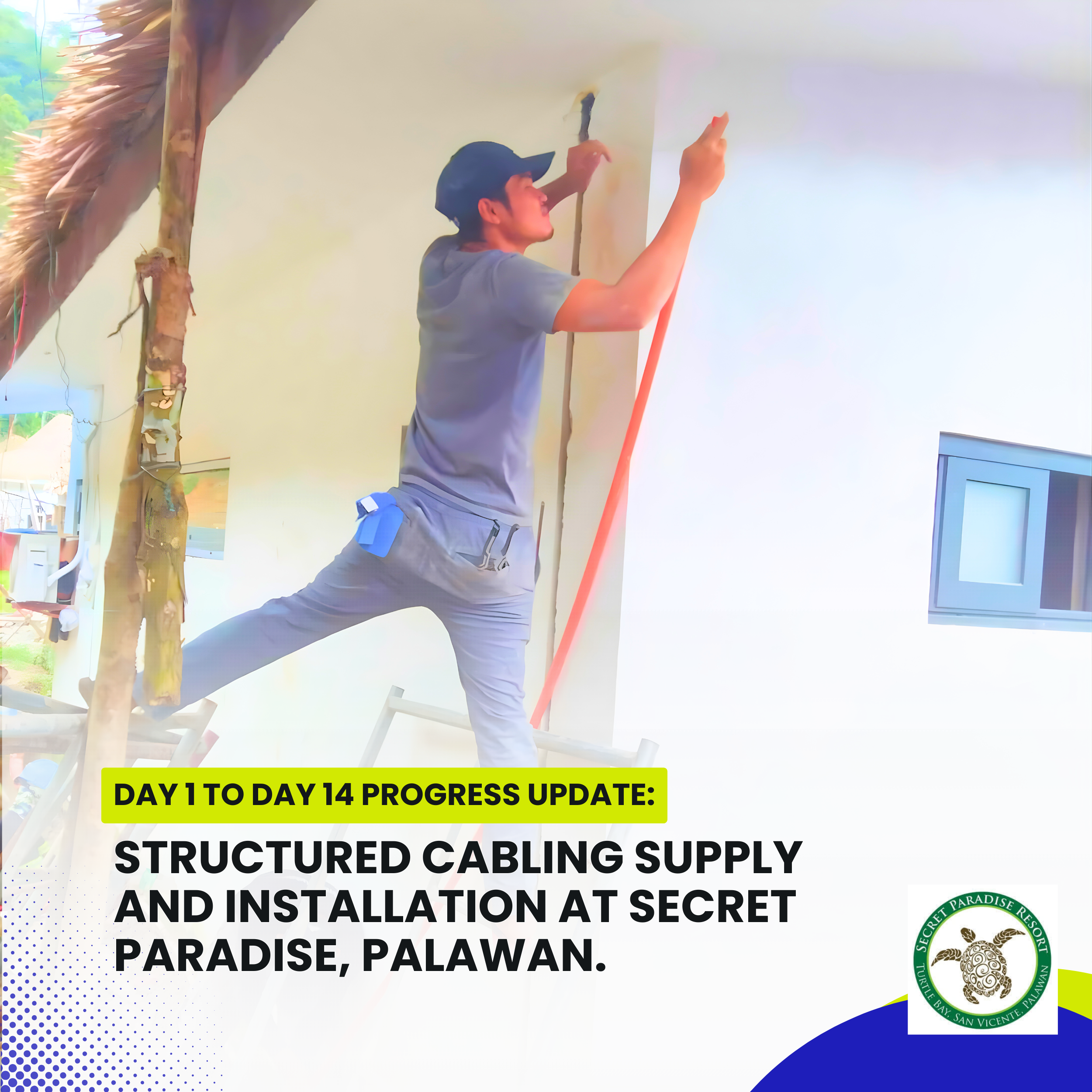

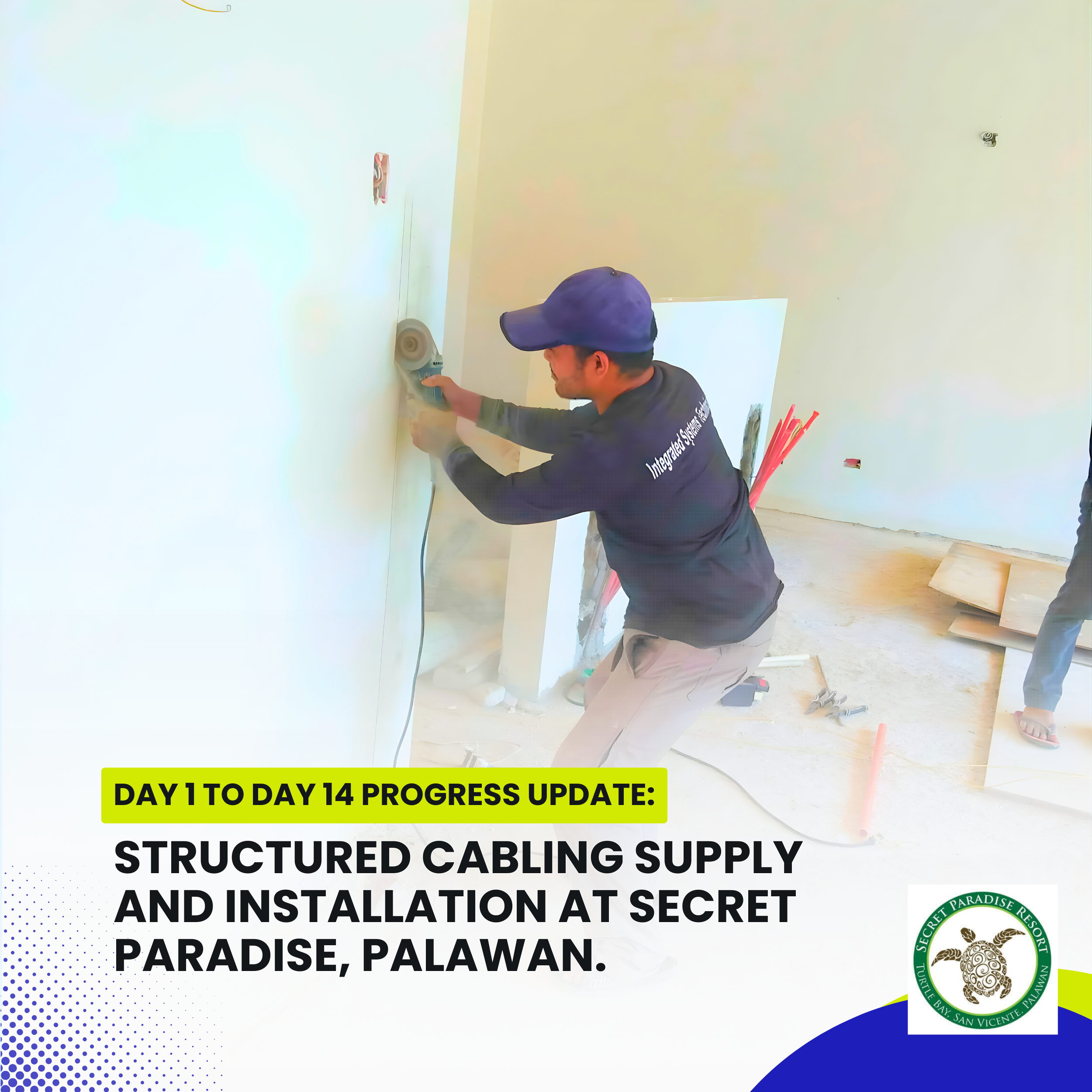

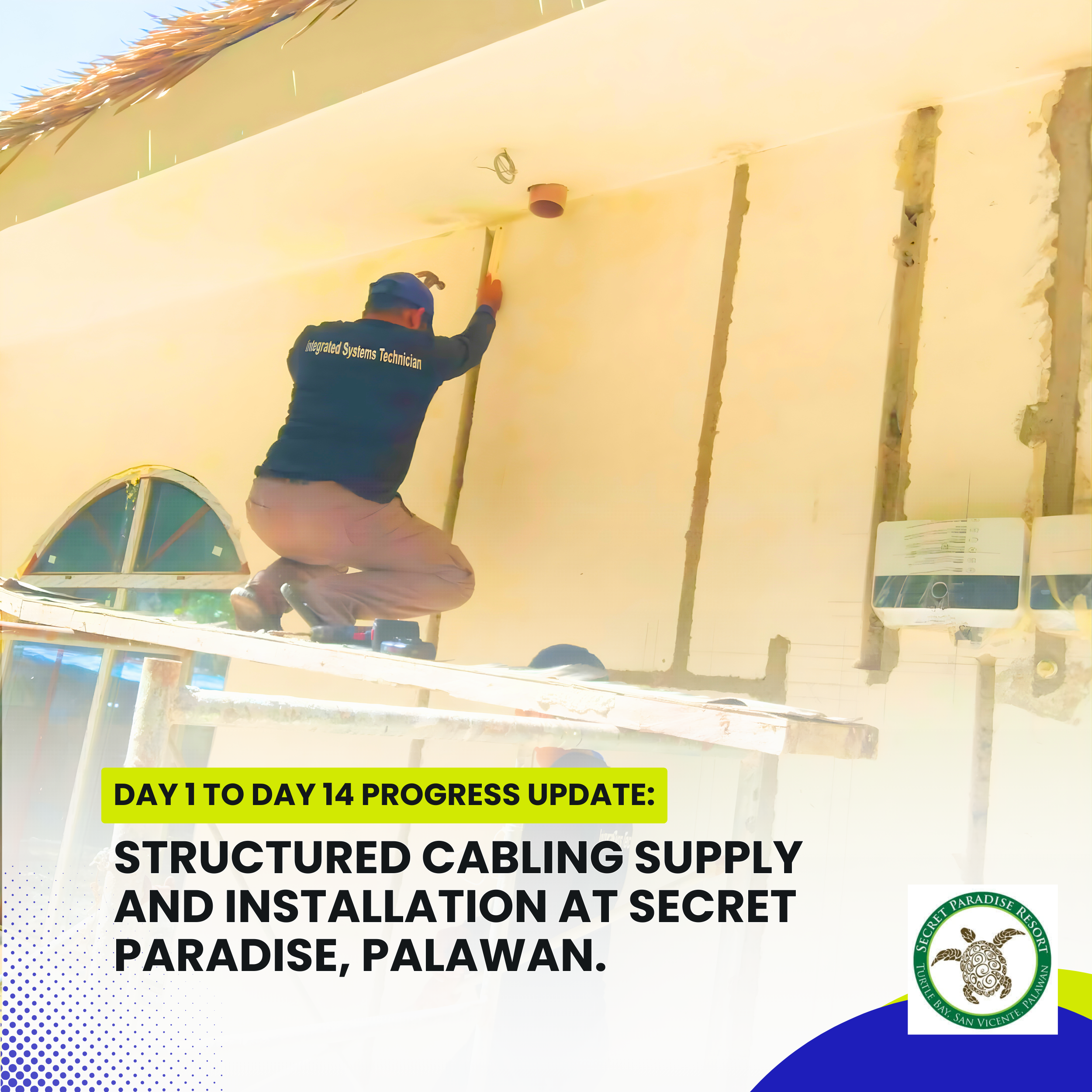

The project’s initial task focused on setting up the intercom piping system in each designated room. The team began operations on October 31, 2025, working systematically to route conduits that would later house the communication lines necessary for the intercom system. The design plan required precise measurement and alignment of pipes along the walls and ceilings to ensure a clean, efficient layout that adhered to both the technical design and the ongoing construction environment.

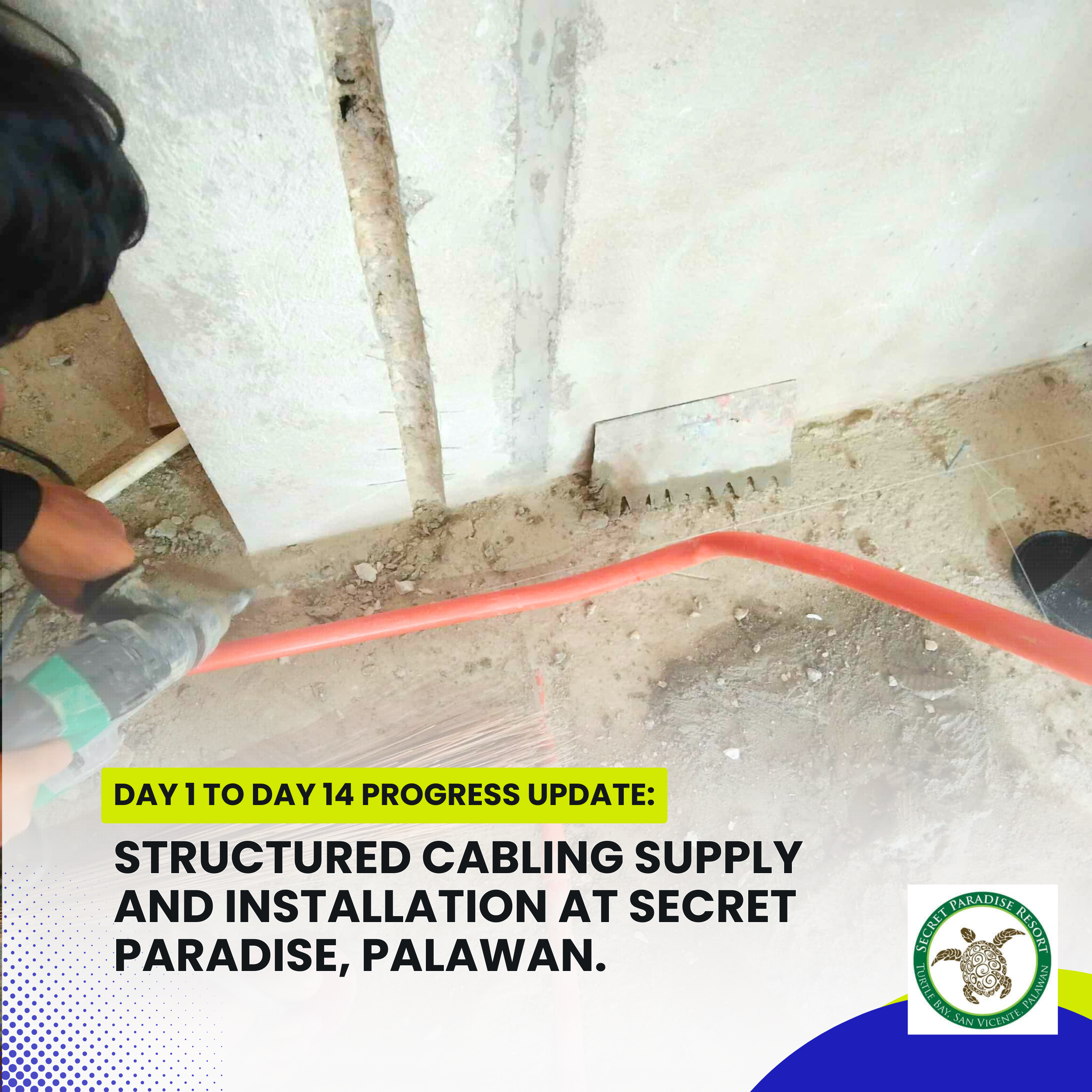

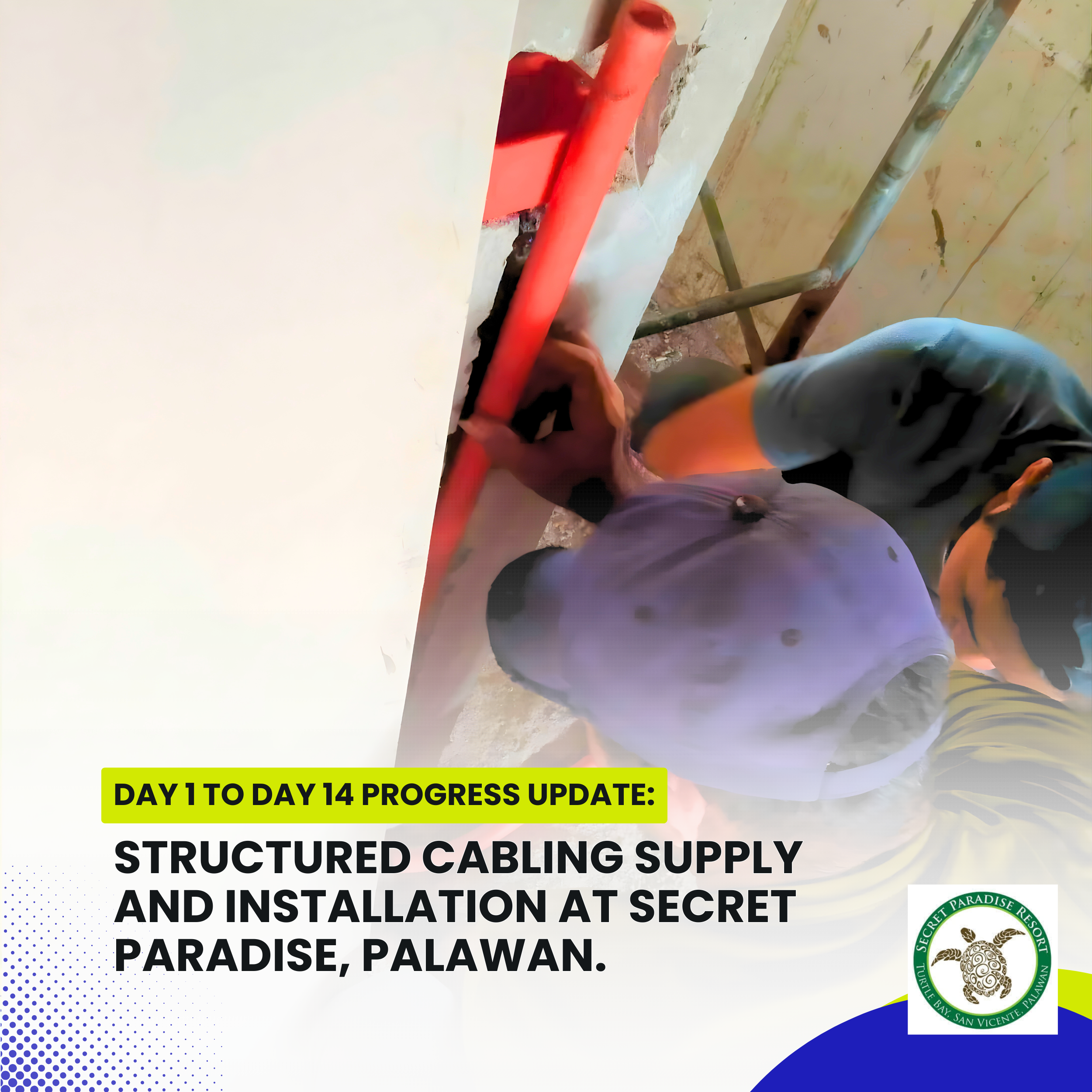

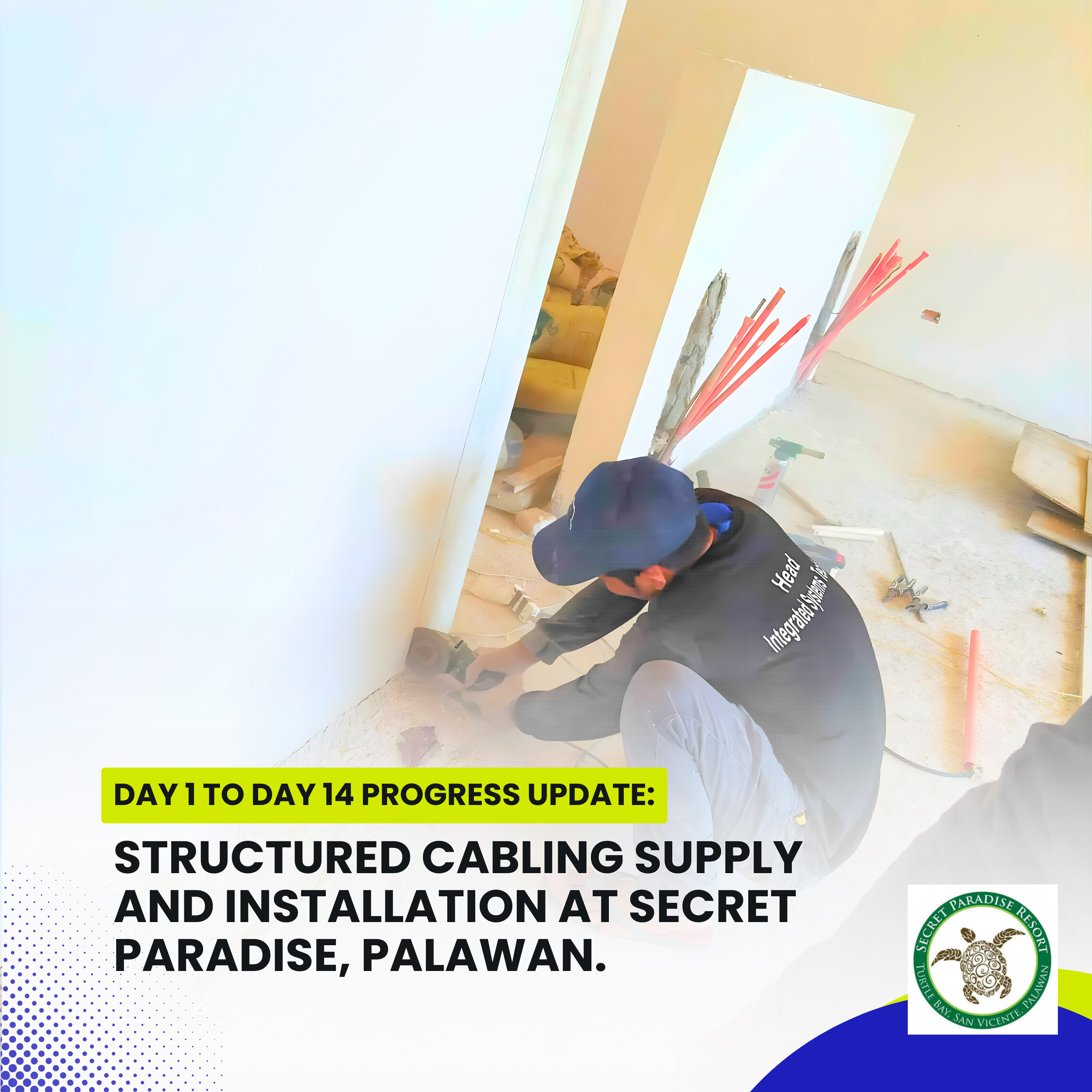

Each room’s conduit line was carefully installed to accommodate the intercom’s wiring network. By the end of the first phase, the team successfully completed piping work for a total of 11 rooms. Every pipe was properly secured and aligned according to the system layout to prepare for the next stage of cable pulling and connection.

Dedication and Team Effort.

Completing the first phase of piping required not just technical expertise but also immense dedication from the entire team. The work extended beyond regular hours, with team members spending long days and frequent overtime shifts to meet the project’s schedule and deliver the first phase on time.

The nature of the installation demanded a high level of precision, as the conduit layout would later determine the effectiveness and neatness of the overall intercom system. The InstallersPH team remained committed to maintaining their standard of quality, ensuring each room’s piping followed the project’s design plan while remaining adaptable to on-site conditions.

The completion of 11 rooms within a limited timeframe stands as a testament to the team’s perseverance, efficiency, and collaboration under demanding circumstances.

On-site Challenges.

Despite the visible progress, the team encountered several on-site challenges that slowed down operations. One of the main issues involved the client’s assigned workers who were supposed to assist in coordinating with the installation crew. These workers would occasionally leave their assigned posts, making it difficult for the team to locate them when additional support or coordination was needed.

Furthermore, since the installation crew was not yet fully familiar with the client’s on-site personnel, it became challenging to identify and communicate with the appropriate workers. The lack of proper coordination sometimes led to delays in material transport, workspace preparation, and access clearance, which in turn affected the overall workflow.

The absence of consistent assistance from the client’s side created periods of downtime, forcing the team to adjust their schedules and reallocate manpower to maintain productivity. These setbacks, while frustrating, were handled with patience and professionalism by the team, who continued to push forward despite the unpredictable work conditions.

Construction-Related Delays.

Coordination and Site Management.

Team Perseverance and Work Ethic.

Conclusion and Next Steps.

Case Studies

AccessPoint Supply and Installation at Santo Niño Village-Final Progress Update. Introduction. Reliable wireless connectivity is essential in today’s homes, supporting daily communication, work, and entertainment needs. To ensure stable and extended network …

CCTV Site Inspection at Guadalupe, Nichols Park subdivision. Introduction. Ensuring the reliability and performance of surveillance systems is essential in maintaining safety and security within residential communities. On this day, InstallersPH IT …

CCTV Structured Cabling at Amara Residences- 4th Progress Update. Introduction. The fourth progress milestone of the project focuses on the installation and configuration of the network infrastructure within the client’s facility. With …
